Public and government projects

Sarawak Coastal Road Network

The Sarawak Coastal Road Network is set to provide the Sarawak’s coastal area with better access and seamless connectivity between towns namely – Kota Samarahan, Sadong Jaya, Sebuyau, Kabong, Tanjong Manis, Daro, Matu, Balingian and Bintulu to the Pan Borneo Highway network and the Second Trunk Road project.

The network spans about 312km, and takes up five hours of driving at 60km/hour on a JKR R3-standard road.

This travel duration is excluding time taken for ferry crossings, which is supposed to be replaced by bridges in the near future.

Related Articles

The Sarawak government plans to connect the Sarawak Coastal Road Network to the Pan Borneo Highway.

Bridges along the Sarawak Coastal Road Network

Eight bridges as seen below will be part of this massive road network.

Sungai Sarawak bridge, Kuching/Samarahan

  • Construction began: 6 January 2021
  • Schedule completion: 7 January 2025
  • Funding: RM370mil from Sarawak Government
  • Length: 1.3km
  • Connects: Sejingkat and Samarahan
  • Contractor: KACC Construction Sdn Bhd

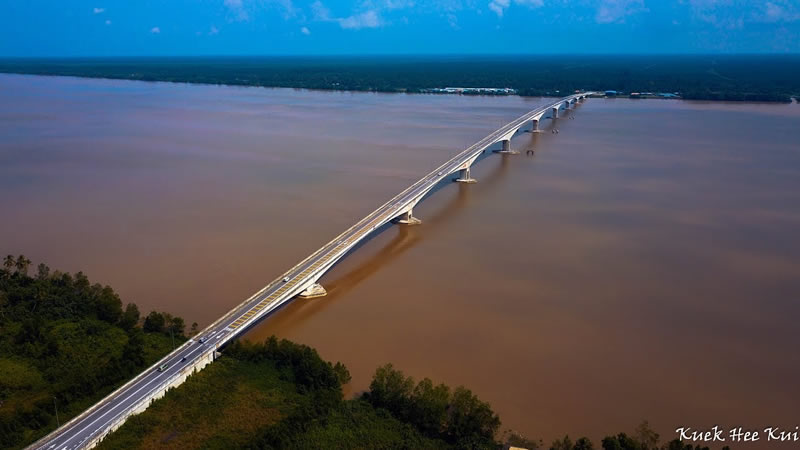

Batang Sadong bridge, Samarahan

  • Construction began: 5 July 2012
  • Completed: 16 October 2016
  • Funding: RM231mil from Federal government
  • Length: 1.48km
  • Connects: Sadong Jaya and Sadong (Simunjan)
  • Contractor: KACC Construction Sdn Bhd

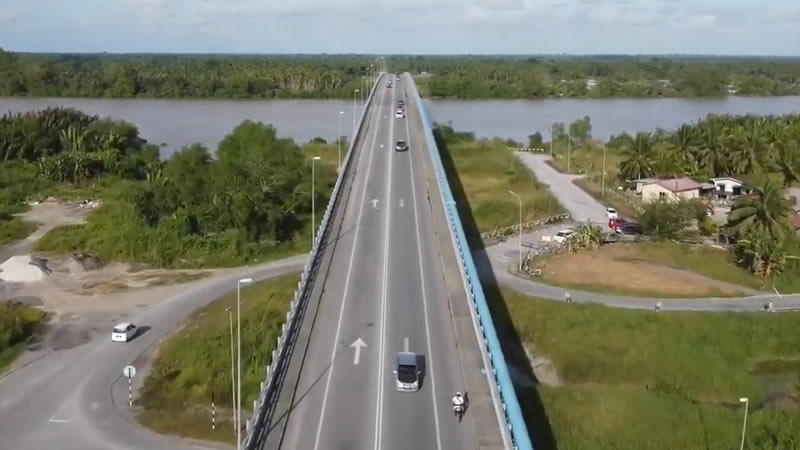

Batang Samarahan bridge, Samarahan

  • Construction began: July 2012
  • Completed: 8 June 2018
  • Funding: RM110mil from Federal government
  • Length: 774m
  • Connects: Kota Samarahan and Asajaya
  • Contractor: Pekerjaan Piasau Konkerit Sdn Bhd

Batang Rambungan bridge, Kuching

  • Construction began: 17 December 20191
  • Schedule completion: 10 March 2023
  • Funding: RM98.5mil from Sarawak Government
  • Length: 560m
  • Connects: Kuching and Lundu
  • Contractor: Precious Credence JV Gezhouba Sdn Bhd

Batang Lupar bridge, Betong/Samarahan

  • Construction began: 23 March 2020
  • Schedule completion: 9 June 2024
  • Funding: RM200 million from Sarawak Government
  • Length: 870m
  • Connects: Sri Aman and Betong
  • Contractor: Naim Gamuda (NAGA) JV Sdn Bhd.

Batang Igan bridge, Mukah

  • Construction began: 24 July 2020
  • Earth breaking: 12 September 2020
  • Schedule completion: 23 Janyary 2024
  • Funding: RM285mil from Sarawak Government
  • Length: 1.4km
  • Connects: Daro to Mukah
  • Contractor: Syarikat Kontrektor Wisma Sdn Bhd

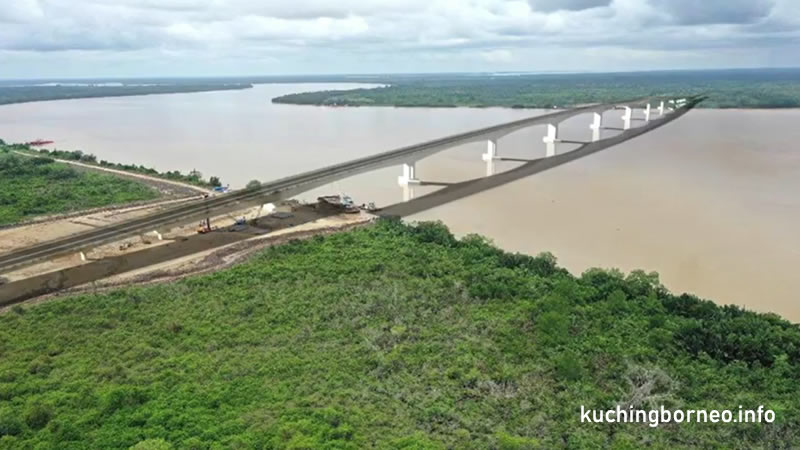

Batang Paloh bridge, Mukah

  • Construction began: 8 May 2019
  • Earth breaking: 22 August 2019
  • Schedule completion: 20 August 2023
  • Funding: RM299mil from Sarawak Government
  • Length: 1.7km
  • Connects: Tanjung Manis to Pulau Bruit
  • Contractor: Hock Seng Lee Bhd (HSL)

Muara Lassa bridge, Mukah

  • Construction began: 22 March 2019
  • Earth breaking 8 September 2019
  • Schedule completion: 8 August 2023
  • Funding: RM598mil from Sarawak Government
  • Length: 2.43km
  • Connects: Daro to Pulau Bruit
  • Contractor: OPUS Consultant (M) Sdn Bhd and Project Consultant is Jurutera Jasa (Sarawak) Sdn Bhd.

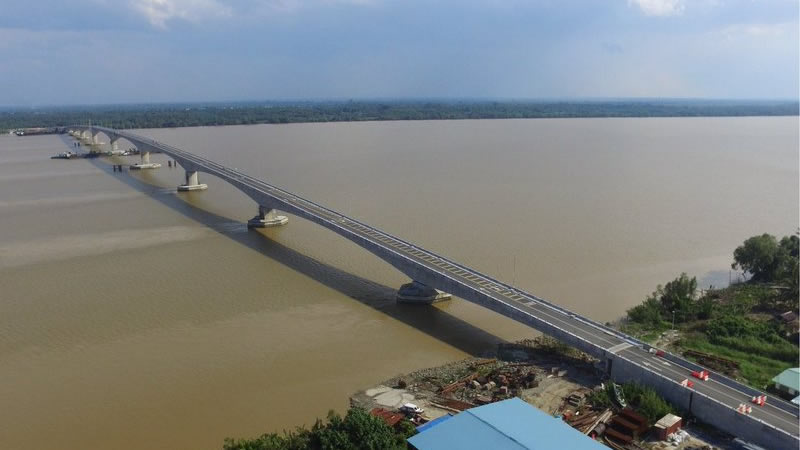

Batang Rajang bridge, Sibu

  • Construction began: 22 March 2019
  • Earth breaking 6 April 2019
  • Schedule completion: 7 July 2023
  • Funding: RM321mil from Sarawak Government
  • Length: 1.2km
  • Connects: Sarikei and Tanjung Manis
  • Contractor: Metrobite Engineering Sdn Bhd

Batang Saribas bridge, Betong

  • Construction began: 3 June 2020
  • Schedule completion: 5 September 2023
  • Funding: RM375.5mil from Sarawak Government
  • Length: 1.55km
  • Connects: Triso, Maludam, Samarang, Beladin, Kabong, Nyabor and Selalang.
  • Contractor: Brooke Dockyard Wijaya Karya JV Sdn Bhd.

Sungai Krian bridge, Betong

  • Construction began: 25 March 2019
  • Earth breaking: 11 June 2020
  • Schedule completion: 21 June 2022
  • Funding: RM75mil from Sarawak Government
  • Length: 690m
  • Connects: Pusa, Sessang, Kabong, Nyabor and Selalang
  • Contractor: EPR (Kuching) Sdn Bhd

Batang Bintulu (Bintulu – Jepak) bridge, Bintulu

  • Construction began: 3 April 2019
  • Earth breaking 22 July 2019
  • Schedule completion: 8 July 2023
  • Funding: RM467mil from Sarawak Government
  • Length: 1.2km
  • Connects: Mukah to Bintulu and Kuala Kemena to Bintulu Town
  • Contractor: PPES Works CCCC JV Sdn Bhd
